From BOQ Progress to Payment Request, in One Wizard.

Build payment requests directly from BOQ items in a 4-step wizard. Import progress from inspections, recover advance payments, see retention and VAT deductions, and submit with a certification signature for approval.

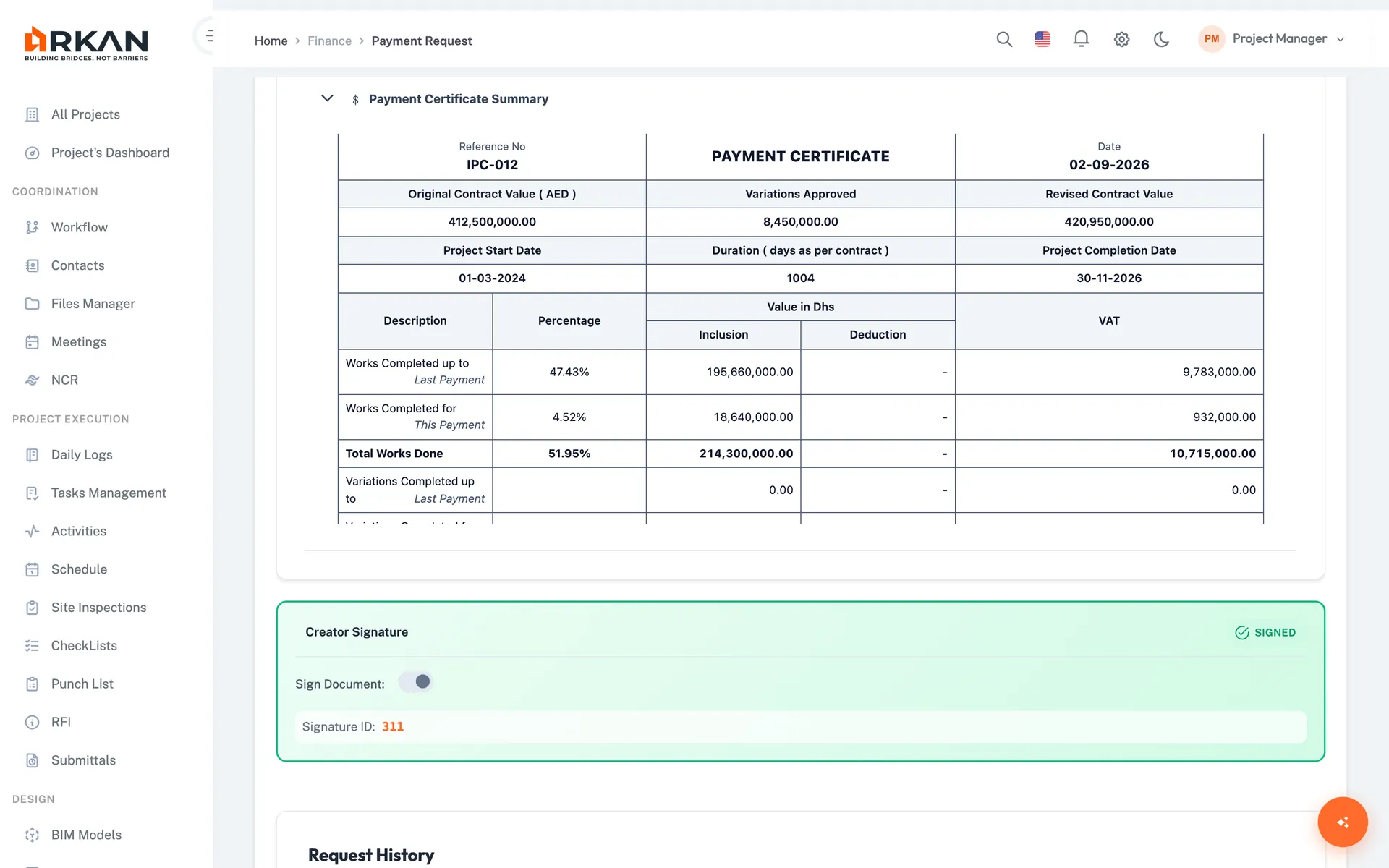

Payment request preview showing retention, advance recovery, VAT and the certification signature

Choosing Arkan

Review a payment request from its supporting project records

Arkan prepares payment requests from project BOQ items through a four-step wizard. Teams can import progress from inspections, link advance payments for recovery, and review retention, VAT and supporting documents before certification and submission. Your project team checks quantities and contract treatment as part of that review.

What to check in your demonstration

  1. Check the period, items and progress

    Review the request's payment period, project contract values and selected BOQ items. Check any progress imported from inspection reports against the work being claimed.

  2. Review recoveries and the payment summary

    Inspect linked advance payments and their recovery amounts, then review the certificate and payment summaries, including retention, VAT and supporting documents.

  3. Inspect certification and the review route

    Check the accuracy confirmation, signature and approval-workflow preview. Review the submission requirements and the PDF export before sending the request.

Who this workflow is for

For quantity surveyors, contractors, project managers and finance teams evaluating how BOQ progress supports a project payment request.

Bring your project context

Bring a sample BOQ, a payment period, relevant inspection records and your advance-payment and retention arrangements. Agree the reviewers and checks required by your project.

Plan the licence and implementation scope

Arkan is licensed annually for each named project, with no per-user fees. Each project includes Platform Foundation plus the workflow packs you select. Implementation, data migration and training are scoped and priced separately in a statement of work.

Review the pricing model

The Payment Certificate Bottleneck

  • 1Preparing a payment certificate means manual BOQ-to-spreadsheet reconciliation every month
  • 2Retention, advance recovery and variation adjustments are calculated by hand, and errors delay payments
  • 3Consultants reject certificates because supporting documentation is incomplete or inconsistent with the BOQ
The Solution

Arkan Payment Certificates & IPCs Capabilities

BOQ-Linked Progress

Select BOQ items for the payment period and import progress from inspection reports. The summary shows total work done, certified amount, overall progress and net payable.

4-Step Payment Request Wizard

Main information, BOQ selection, advance payments, and preview & submit. Changing the payment period reloads contract values, variations and previous payments.

Advance Payments, Retention & VAT

Link mobilization and material advances and set recovery amounts. The payment summary shows retention and VAT deductions, and retention releases are tracked separately.

Certification & Approval

Confirm accuracy with the certification checkbox and digital signature, then submit to the approval workflow. Submit stays disabled until every validation passes.

How It Works

Simple 4-Step Process

1

Start: Enter issue date, payment number and payment period

2

Select: Pick BOQ items and import progress from inspections

3

Recover: Link advance payments and set recovery amounts

4

Submit: Review the certificate summary, sign and send for approval

Key Capabilities

At a Glance

Wizard Steps

4

Main info, BOQ selection, advance payments, preview & submit

Deductions

Retention & VAT

Shown in the payment summary before submission

Submission Check

Validated

Submit is enabled only after all checks pass and the request is certified

Worked Example

From BOQ Progress to a Payment Request: Worked Example

How quantities measured this period become the net amount payable, after retention and advance payment recovery.

ItemDescriptionUnitRate (AED)Previous qtyThis period qtyThis period value (AED)Cumulative value (AED)
1.01Blockwork, 200 mmm²85.001,50090076,500.00204,000.00
2.03Internal plasterm²32.002,0002,50080,000.00144,000.00
3.07Porcelain floor tilingm²140.00060084,000.0084,000.00
Gross value of work done to date
432,000.00
Less: gross value previously certified
(191,500.00)
Gross value this period
240,500.00
Less: retention at 10% of this period
(24,050.00)
Less: advance payment recovery at 5% of this period
(12,025.00)
Net payable this period (AED, before VAT)
204,425.00

Illustrative figures for explanation only, not from a real project. Your contract sets the rates, the retention percentage and how advances are recovered; VAT is left out here because its treatment depends on your contract and tax position. In Arkan, the payment request preview shows work done, previous amounts, advance payment recoveries and deductions (including retention and VAT) before you submit. Try your own figures in the free IPC calculator.

Download this example as an Excel file (.xlsx)
FAQ

Payment Certificates & IPCs: Common Questions

What should I have ready before creating a payment request?

Select the project and upload its BOQ. Your administrator can check Finance access and the Insert permission needed to create a request, and configure the approval workflow if routing is required. Before submission, review the supporting documents and approval-chain preview, resolve validation issues and complete certification. You can save a draft while preparing the request.

Payment request prerequisites and submission checks
How is a payment request built from the BOQ?

A 4-step wizard: main information (payment period, contract values), BOQ selection, advance payments, then preview and submit. In the BOQ step you tick the items being claimed; the table shows item code, description, quantity, unit, unit rate, total value and the previous amount, and you can import progress from inspection reports. A summary panel shows total work done, certified amount, overall progress and net payable. The BOQ must be uploaded first.

How the BOQ is imported
Does it handle retention and advance payment recovery?

Yes. In step 3 you link advance payments (for example mobilization or material advances) to the request so their recovery is deducted. Advances are set up as an amount or a percentage, with installments, and can be linked to the BOQ. The Retention section tracks the retention percentage, total withheld, total released and the balance, and a release wizard handles the first half at completion and the second half a year later.

Retention calculator
Who approves a payment request, and can it still be edited?

Before submitting, the person preparing the request completes the certification: an accuracy checkbox, digital signature, recommendation, department and notes. On submit the status moves from Draft to New and the request follows the approval workflow your administrator configured; the preview shows that approval chain. Requests end as Approved, Rejected or Returned, and only drafts can be edited or deleted.

Does Arkan replace the engineer's or consultant's certification?

No. Arkan records the request, the certification details and each approval step, but who certifies and on what terms is set by your contract. Arkan does not certify payments or give contractual or tax advice.

Can I export the payment certificate?

Yes. From the preview you can submit, save a draft or export a PDF. Finance grids also export to Excel (.xlsx) and PDF.
